Cover: 4D in IFC for Beginners - 13 steps from zero to animation, with Marcin Pszczolka

4D in IFC for Beginners: from a bridge with no schedule to a construction animation

You have an IFC 4.3 bridge that says nothing about time. This guide takes that file and, in 13 steps (about 40 minutes), adds a construction schedule, links every task to the geometry and renders an MP4 of the bridge being built. Everything is done by clicking in Bonsai 0.8.5 (free, inside Blender 5.1), and every screenshot below is a real Bonsai screen with the click targets marked 1 2 3.

The result: an 87 m concrete bridge building itself over five construction stages, driven by the schedule you will enter below.

Starting model: the BR-01 bridge (IFC4X3_ADD2, 203 physical products) with geometry intact and zero work plans, schedules and tasks.

1 · What 4D actually is in IFC

4D = 3D + time. Your model already answers what and where. 4D adds when it gets built.

The key thing to understand: IFC contains no animation. It stores a schedule as plain data. The animation is computed afterwards by software, here Bonsai. So a 4D IFC is really three things that have to be connected:

BLOCK 1 – the bridgePhysical productsIfcFooting · IfcColumn
IfcWall · IfcSlab · IfcBeam
IfcBearing · IfcRailing
↔IfcRelAssignsToProduct
“this task builds that element”
BLOCK 2 – the scheduleTasksIfcWorkPlan
└ IfcWorkSchedule
  └ IfcTask (T10, T10.1 …)
↔
BLOCK 3 – timeTask datesIfcTaskTime
ScheduleStart / Finish
+ IfcRelSequence (order)

Naming a task “Foundations A1” does not connect it to any footing. The link (IfcRelAssignsToProduct) has to be made on purpose. That single relationship is the heart of 4D.

The IFC vocabulary you need (and no more)

Entity In plain words Role
IfcWorkPlan a folder for schedules optional, keeps things tidy
IfcWorkSchedule the schedule holds the task tree
IfcTask a job or construction stage “Foundations”, “Deck casting”…
IfcTaskTime the task’s dates start, finish, duration
IfcRelNests nesting child task inside a parent (T10 → T10.1)
IfcRelAssignsToProduct “this task builds this element” what the animation is built from
IfcRelSequence dependency “B starts after A finishes”
IfcLagTime delay on a dependency e.g. “+3 days after A”
IfcRelAggregates decomposition a railing made of posts – not a task link

How the film is derived

For every element that a task builds, Bonsai writes keyframes:

  • before the task starts: the element is invisible (not built yet)
  • during the task: green (under construction)
  • after it finishes: light grey (completed)

Three rules of 4D

1) A task with no dates animates nothing. 2) A task with no assigned elements animates nothing. 3) An element with no task stands there from the very first frame.

2 · What you need

Item Version / file
Blender 5.1
Bonsai 0.8.5 (Edit → Preferences → Get Extensions → search “bonsai”)
Starting model Bridge_START_no_4D.ifc – the BR-01 bridge, geometry intact, zero work plans, schedules and tasks
For comparison 03_Bridge_BEST_IFC4x3.ifc – the same bridge with the finished schedule


IFC2X3 files cannot do this

Bonsai does not draw the Work Schedules panel for IFC2X3. 4D in Bonsai needs IFC4 or newer. That is one of the practical reasons to deliver bridges in IFC 4.3.

Tip before you start: the Properties column is narrow by default and clips button labels. Drag the border between the 3D viewport and Properties to the left until it is about 420–520 px wide. For the long forms in Steps 4–9, hover over Properties and press Ctrl+Space to maximise it (same key to restore).

3 · The plan we will enter

Five construction stages. The first two are split into one child task per support (A1, P1–P4, A2), so 5 + 12 = 17 tasks. These are exactly the dates stored in the reference model, so you can compare at the end.

ID Task Start Finish Elements to link (Outputs)
T10 Stage 1 – Foundations 2027-04-05 2027-04-29 — (children carry the links)
T10.1 … T10.6 Foundations A1, P1, P2, P3, P4, A2 2027-04-05 2027-04-09 per support: IfcFooting + IfcSlab (blinding) + IfcEarthworksFill (crushed stone bed)
T20 Stage 2 – Piers and abutments 2027-04-30 2027-06-03 — (children)
T20.1 / T20.6 Structure A1 / A2 2027-04-30 2027-05-04 abutment front wall + 2 wing walls (IfcWall)
T20.2 … T20.5 Structure P1 … P4 2027-04-30 2027-05-04 pier wall (IfcColumn)
T30 Stage 3 – Deck casting and bearings 2027-06-04 2027-07-18 bridge deck slab, 2 end diaphragms, 4 bearings
T40 Stage 4 – Edge beams / approach slabs 2027-07-19 2027-08-12 8 edge beams / wing-wall edge beams, approach slabs with blinding and stone beds (14 elements)
T50 Stage 5 – Railings and equipment 2027-08-13 2027-08-27 2 railings and their 100 posts/handrails (IfcMember)

Total span: 5 April → 27 August 2027 = 144 days. Stages are chained T10 → T20 → T30 → T40 → T50 with FINISH_START.

Step 1 · Load the model

▶ Click path

  1. File → Open IFC Project
  2. Pick Bridge_START_no_4D.ifc → Load Project
Bonsai with the bridge BR-01 loaded; Outliner and 3D viewport marked

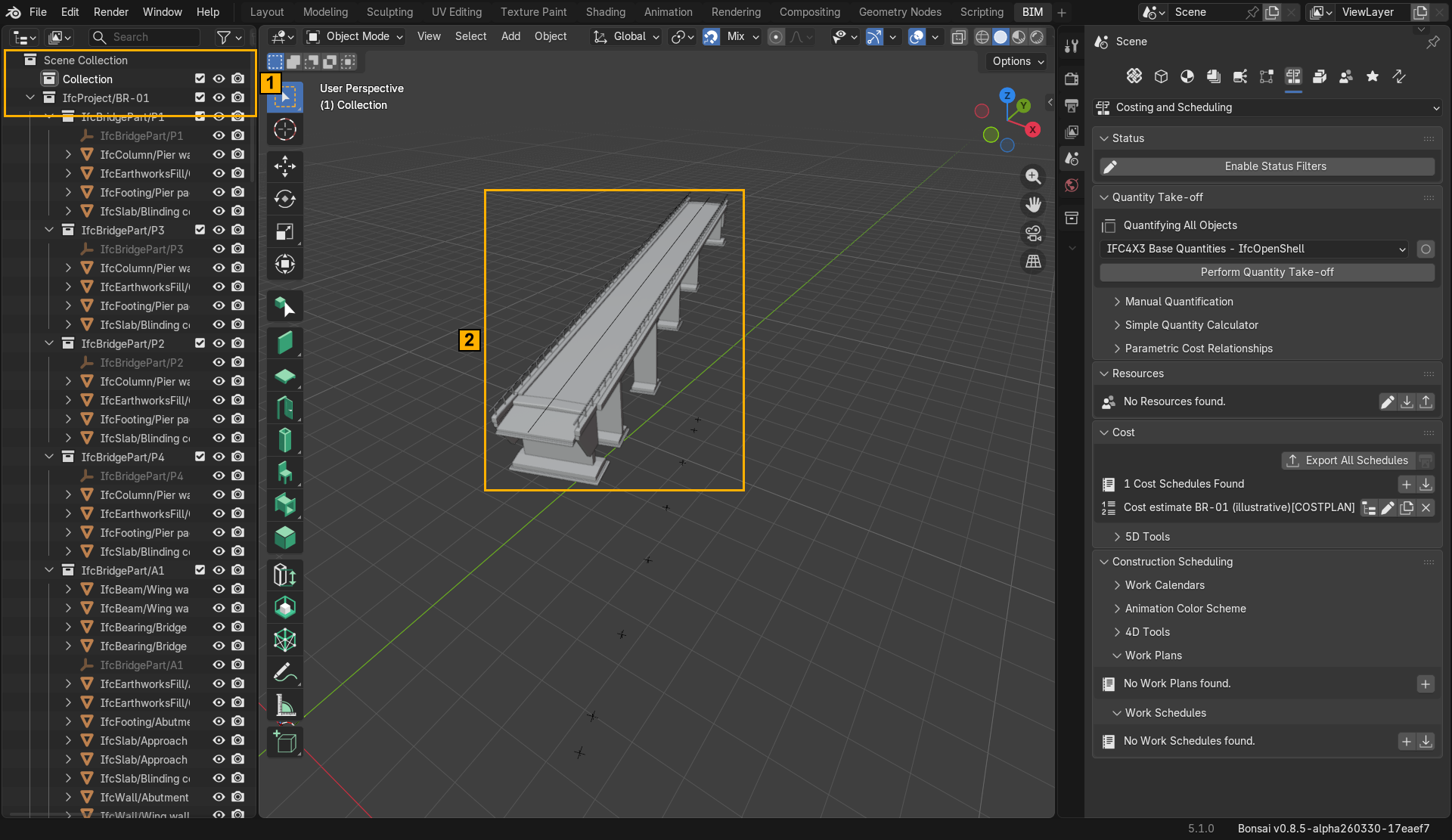

Step 1 – 1 the Outliner shows IfcProject/BR-01 with its bridge parts; 2 the bridge is in the 3D viewport. Real Bonsai 0.8.5 screenshot of Bridge_START_no_4D.ifc.
✔ Checkpoint The bridge is visible in 3D and the Outliner lists IfcProject/BR-01. There are no schedules yet.

Step 2 · Find the scheduling panel

▶ Click path

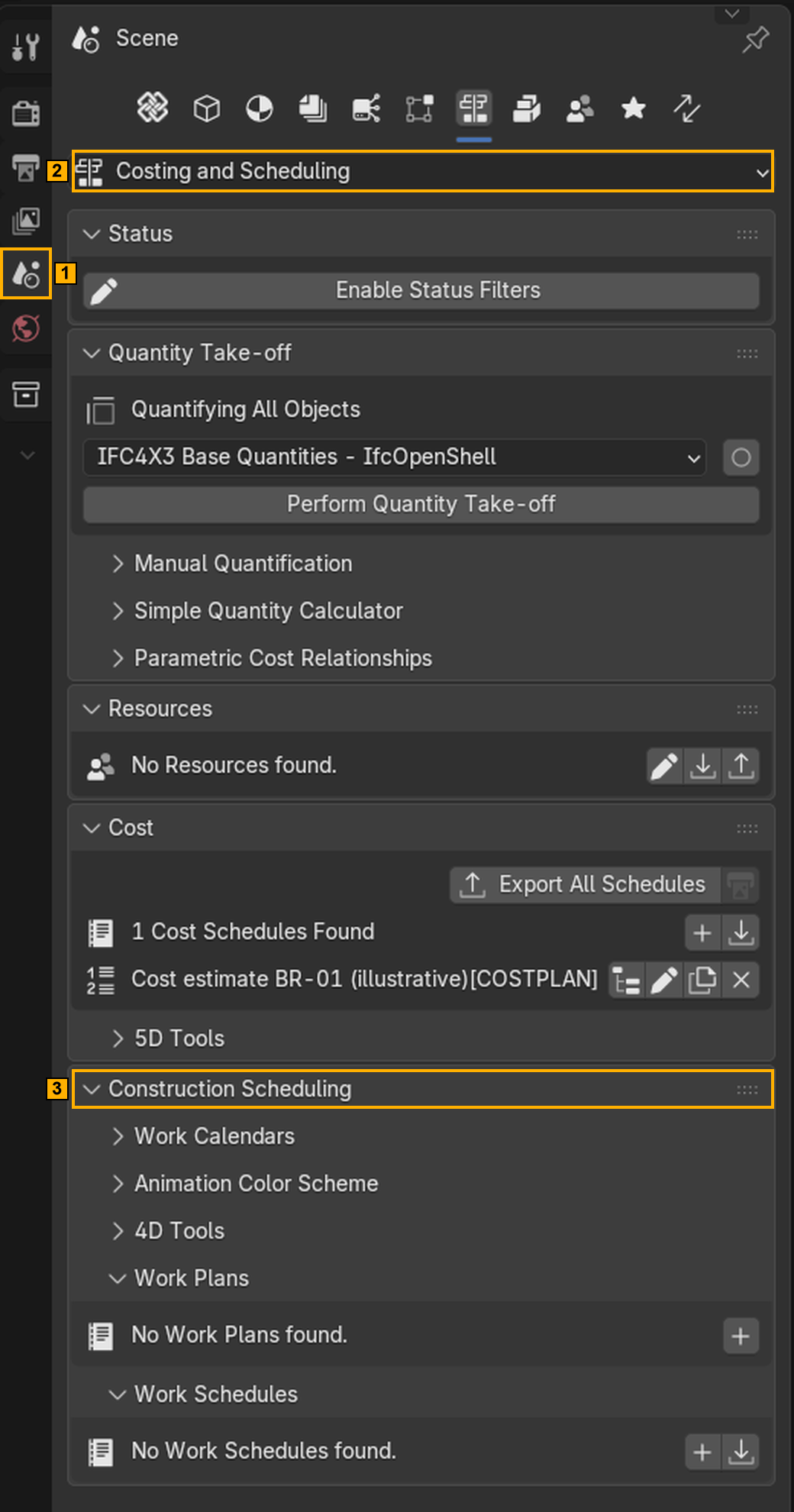

  1. Right column Properties → the Scene tab (cone-and-sphere icon) 1
  2. Open the tab selector at the top and choose Costing and Scheduling 2
  3. Scroll down to Construction Scheduling 3 (it contains Work Plans and Work Schedules)
Properties Scene tab, Costing and Scheduling selector and Construction Scheduling group marked

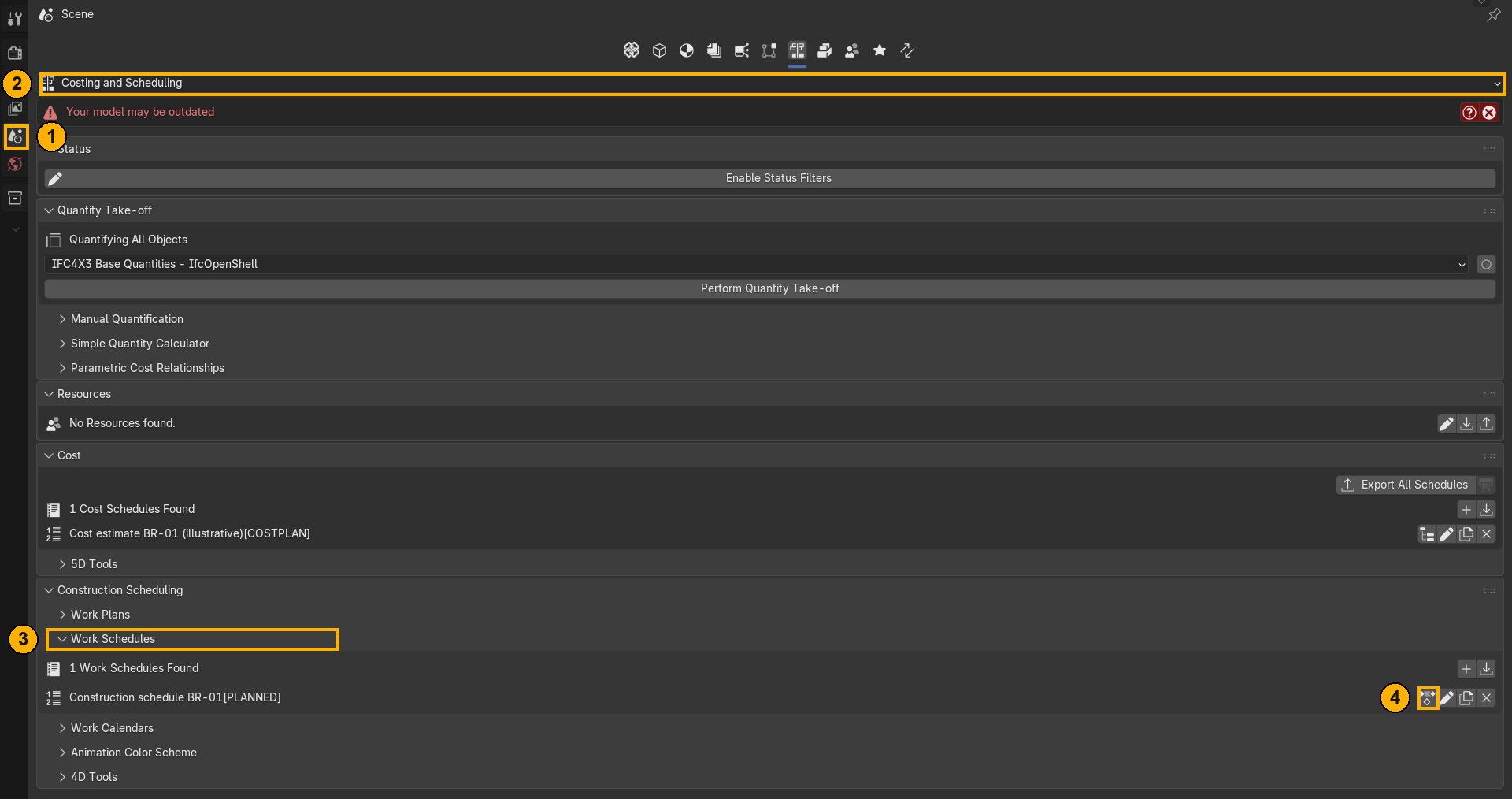

Step 2 – 1 Properties → Scene tab · 2 the tab selector set to Costing and Scheduling · 3 the Construction Scheduling group, where all 4D work happens.

Step 3 · Create the work plan and the work schedule

IfcWorkPlan is a folder; IfcWorkSchedule is where the task tree lives. Right now both lists are empty.

Work Plans and Work Schedules lists empty with the plus buttons marked

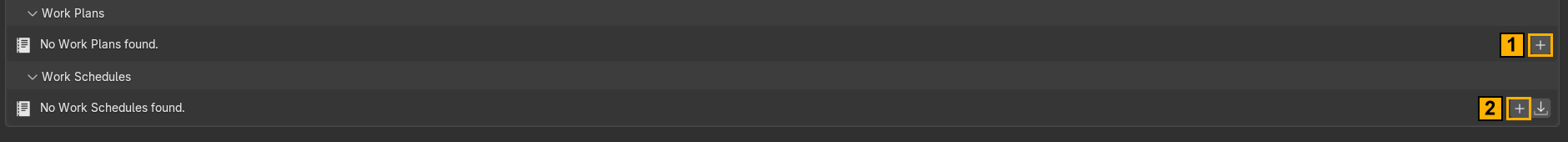

Step 3 – nothing exists yet: No Work Plans found, No Work Schedules found. 1 the + next to Work Plans · 2 the + next to Work Schedules.

▶ Click path

  1. Work Plans → + 1 – a plan appears. Click its pencil and name it Construction plan BR-01.
  2. Work Schedules → + 2 – a dialog opens. Name: Construction schedule BR-01, Type: PLANNED → OK.
  3. Optional: the first icon on the plan row lets you attach the schedule to the plan.
Work plan and PLANNED work schedule created, row icons marked

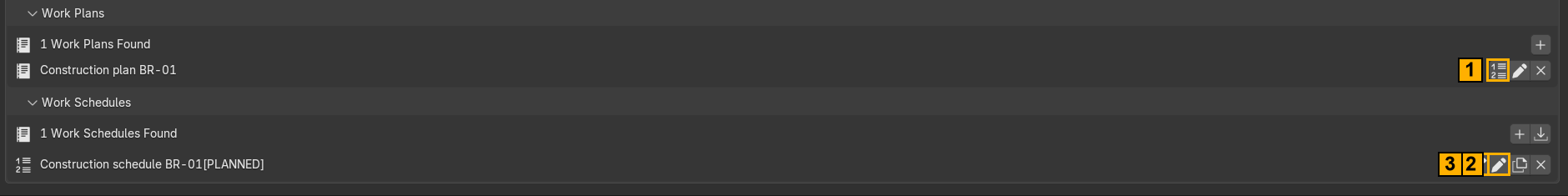

Step 3 – result. One plan and one schedule, Construction schedule BR-01[PLANNED]. 1 plan row: first icon links schedules to the plan · 2 schedule row: pencil = edit name/type · 3 schedule row: first icon = Enable Editing Work Schedule Tasks (next step).
✔ Checkpoint The list reads 1 Work Schedules Found with Construction schedule BR-01[PLANNED]. It has no tasks yet.

Step 4 · Add the five construction stages

Click the first icon on the schedule row (3 in the previous figure). The panel switches to task editing: schedule tools, task tools and the task tree appear.

Do not click the other icons on that row

Left to right they are: edit tasks (the one you want), edit attributes (pencil), duplicate and delete. They have no text labels.

Task editing mode with Add Summary Task, Edit and attribute pencil marked

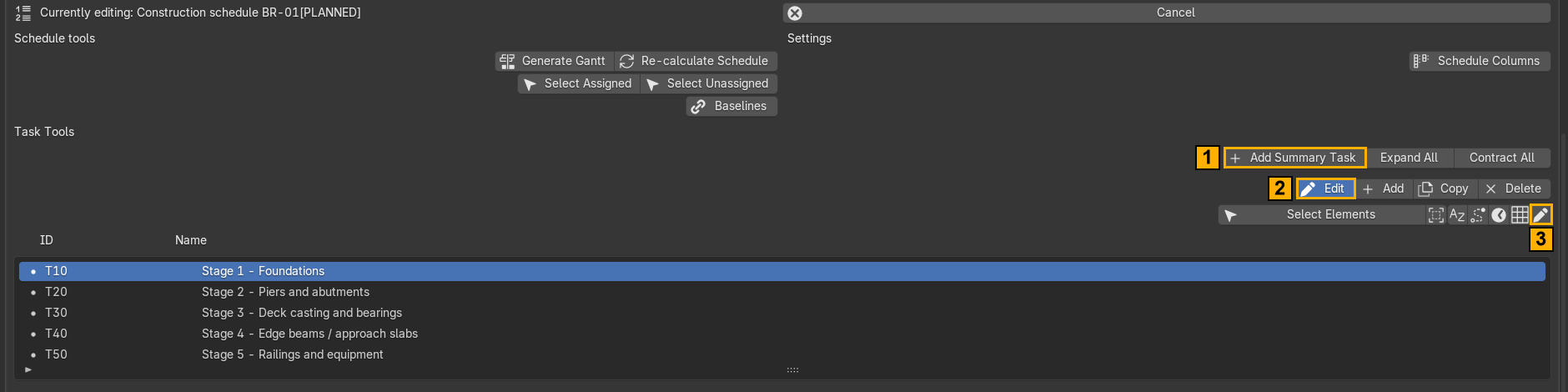

Step 4 – the schedule is in task-editing mode (Currently editing…). 1 Add Summary Task creates a top-level stage · 2 Edit opens the per-task tool row · 3 the pencil in that row edits Name / Identification. The five stages T10–T50 are already in the tree.

▶ Click path – repeat five times

  1. Add Summary Task 1 – a new top-level task appears in the tree.
  2. Select it, click Edit 2, then the pencil 3 in the tool row that appears.
  3. In the form fill in Name, Identification and PredefinedType, then confirm with ✓ (see below).
Task attribute form with Name, Identification, PredefinedType and confirm button marked

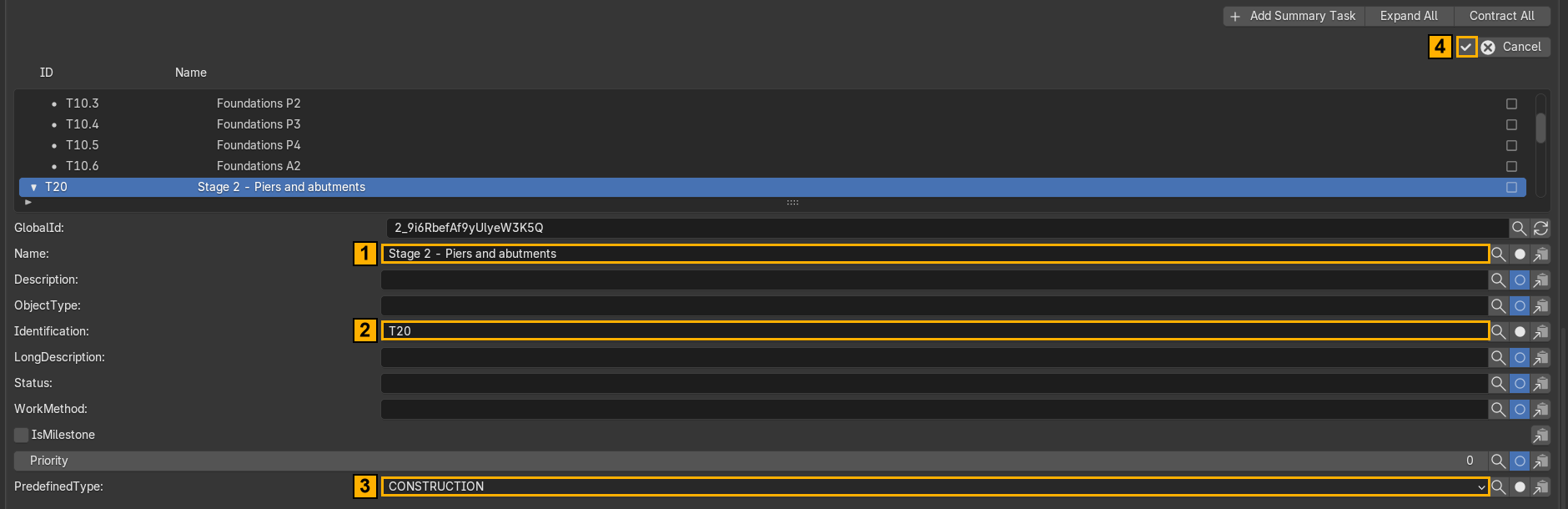

Step 4 – task attribute form. Fill 1 Name · 2 Identification · 3 PredefinedType = CONSTRUCTION, then confirm with 4 the ✓ button (top right).

Use these names and IDs:

Identification Name PredefinedType
T10 Stage 1 – Foundations CONSTRUCTION
T20 Stage 2 – Piers and abutments
T30 Stage 3 – Deck casting and bearings
T40 Stage 4 – Edge beams / approach slabs
T50 Stage 5 – Railings and equipment
✔ Checkpoint Five stages T10–T50 sit in the task tree.

Step 5 · Add a child task for each support

Stages 1 and 2 are done support by support. Child tasks are what you will attach geometry to later; the parent only summarises them (IfcRelNests stores the hierarchy).

▶ Click path

  1. Select T10 in the tree 1.
  2. Click Add 2 six times. Each click adds a child under the selected task.
  3. Edit each child (Edit → pencil): T10.1 “Foundations A1”, T10.2 P1, T10.3 P2, T10.4 P3, T10.5 P4, T10.6 A2.
  4. Repeat under T20 for T20.1 … T20.6 (“Structure A1”, P1–P4, A2).
  5. T30, T40 and T50 stay without children.
Parent task T10 selected and the Add button marked

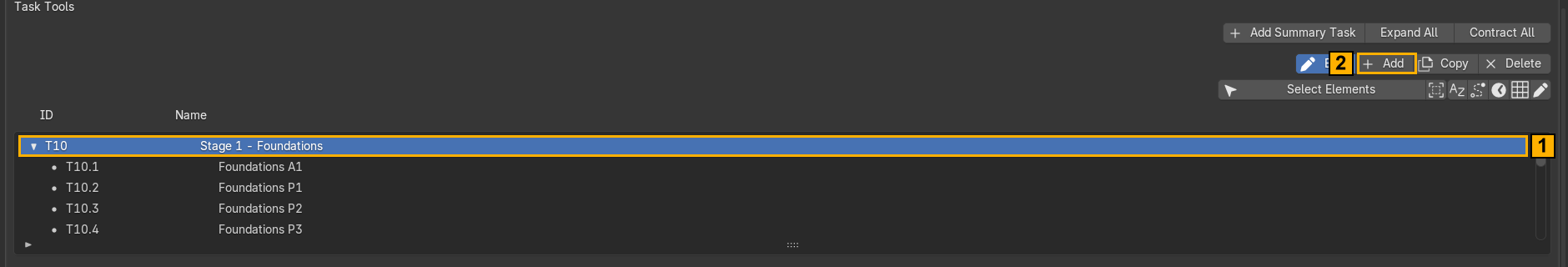

Step 5 – 1 select the parent task (T10) in the tree · 2 click Add: the new task becomes a child. The tree shows T10.1 … T10.4 (T10.5 and T10.6 are below the visible rows).
✔ Checkpoint 17 tasks in total (5 stages + 6 + 6 children). Expand All / Contract All above the tree help with navigation.

Step 6 · Enter the dates

Select a task, click Edit, and pick the clock icon (it is the fourth icon of the tool row below – Enable Editing Task Time).

Task tool row icons: auto-select, reorder, sequence, clock, calendar, pencil
The task tool row that appears after you click Edit (zoomed).
  • 1 auto-select elements when you click a task  ·  2 reorder (A–Z)  ·  3 sequence – dependencies (Step 9)
  • 4 clock – task time (this step)  ·  5 task calendar  ·  6 pencil – name / attributes (Step 4)
Task time form with ScheduleStart, ScheduleFinish and ScheduleDuration marked

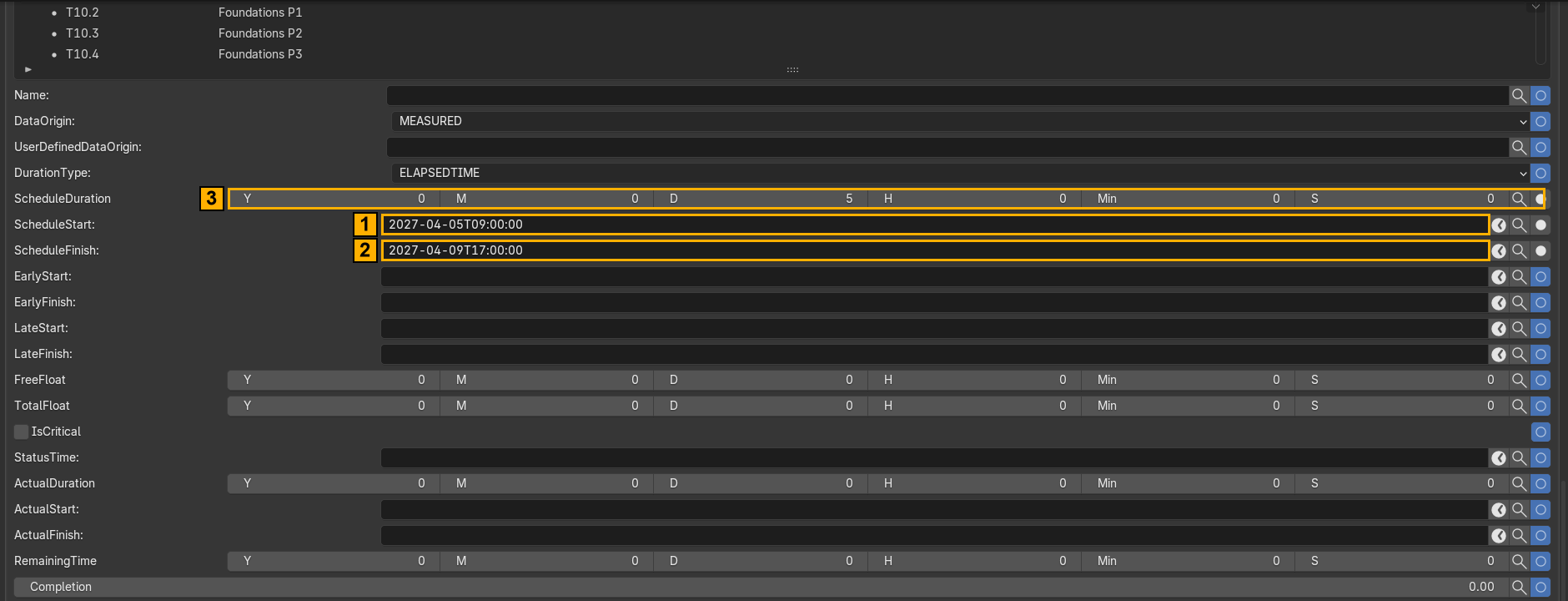

Step 6 – task-time form for T10.1 (opened with the clock icon). 1 ScheduleStart · 2 ScheduleFinish · 3 ScheduleDuration is derived (5 days). Dates use ISO format 2027-04-05T09:00:00. Confirm with the ✓ button at the top of the panel.

▶ Click path – for every task

  1. Select the task → Edit → clock icon.
  2. Fill ScheduleStart and ScheduleFinish in the format 2027-04-05T09:00:00 (the duration follows).
  3. Confirm with ✓ at the top of the task area.

Use the dates from the plan in section 3: T10.x = 5–9 April, T20.x = 30 April–4 May, and the stage rows for T10, T20, T30, T40, T50.

Heads-up: identical dates = one big jump

If all six children have the same dates they all appear at once. In the reference model they do, and the film shows five “jumps” with dead time between them. To get a moving construction front, stagger the child dates (A1 first, then P1, P2 …) or add lag times in Step 9.

✔ Checkpoint Every task shows start and finish. Tasks without dates will not animate.

Step 7 · Link the tasks to the geometry

This is the step that turns a list of names into 4D. It creates IfcRelAssignsToProduct.

Task T10.1 selected, footing selected in 3D and the Outputs plus button marked

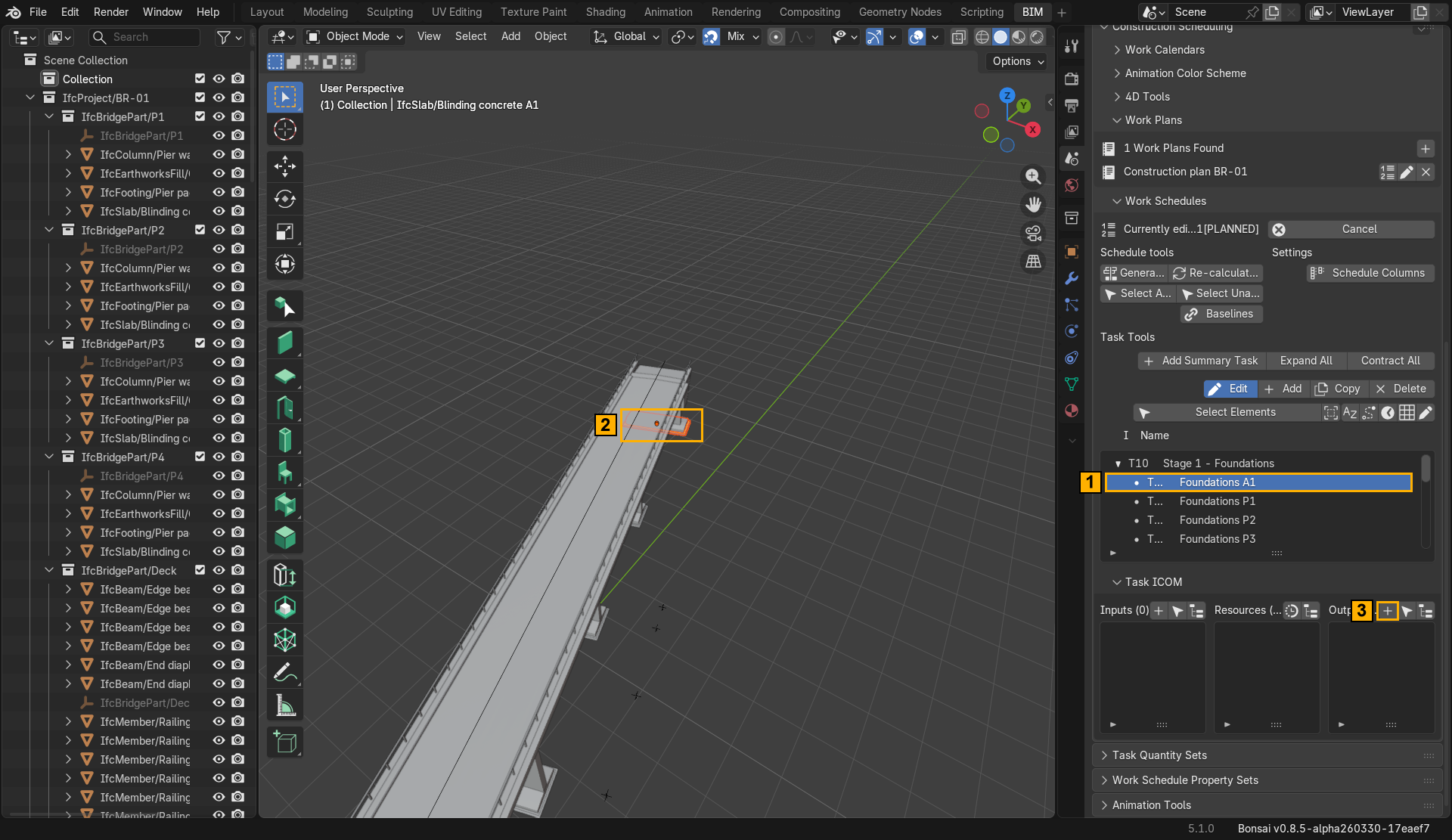

Step 7 – 1 select the leaf task T10.1 · 2 select its elements in the 3D viewport (or Outliner) · 3 in Task ICOM → Outputs click +. The + only appears while objects are selected.

▶ Click path – for every leaf task

  1. Select the leaf task (e.g. T10.1) in the tree 1.
  2. In the 3D viewport (or Outliner) select the elements it builds 2 – see the table in section 3. Box-select or Ctrl-click in the Outliner works well.
  3. Open Task ICOM and click + in the Outputs column 3.
  4. The counter changes from Outputs (0) to the number of assigned elements.

ICOM stands for Inputs / Controls / Outputs / Manpower. 4D uses Outputs: what the task produces. The small arrow icon next to + (Select Task Related Products) selects a task’s outputs in 3D, which is a quick way to double-check a link.

Task ICOM Outputs (3) listing footing, blinding and crushed stone bed

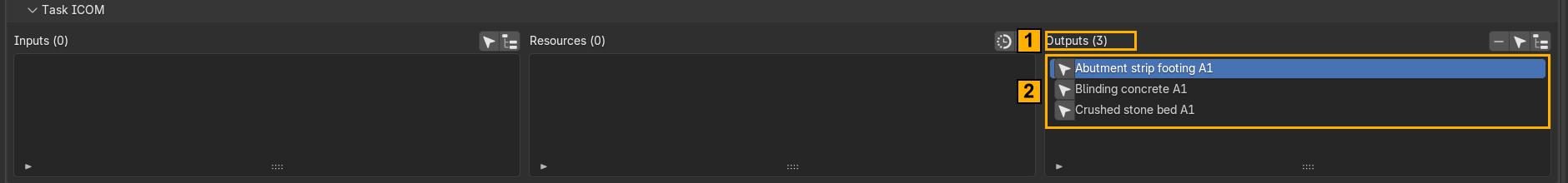

Step 7 – result: 1 the counter reads Outputs (3) · 2 footing, blinding and crushed-stone bed are now outputs of T10.1.

Assign leaf tasks, not parents. For T10.x that is the footing, the blinding slab and the crushed-stone bed of each support; for T20.x the walls or pier wall; for T30, T40, T50 the elements listed in section 3.

✔ Checkpoint Every leaf task shows Outputs (n) with n > 0.

Step 8 · The railing trap: assign the members too

Assigning the two IfcRailing objects to T50 is not enough. Their 100 posts and handrails are separate IfcMember objects connected to the railing only through IfcRelAggregates (decomposition). Bonsai’s animation reads task assignments only and does not walk down the decomposition. Result: 100 railing members hang in mid-air from the very first frame.

Outliner listing IfcMember railing posts that must be assigned to the railing task

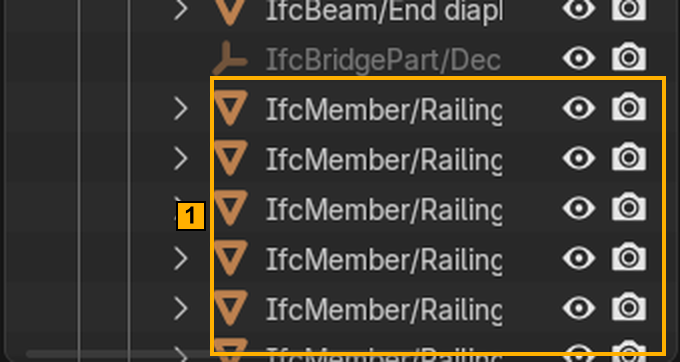

Step 8 – 1 the railing posts and handrails are separate IfcMember objects (100 of them). They must be assigned to T50 too.

▶ Click path

  1. Select task T50.
  2. In the 3D viewport select the two railings and all IfcMember/Railing… objects (in the Outliner: click the first member, Shift-click the last).
  3. Task ICOM → Outputs → +
✔ Checkpoint T50 shows Outputs (102): 2 railings + 100 members.

Step 9 · Add dependencies between stages

Dependencies (IfcRelSequence) say what has to finish before something can start. Chain the five stages with FINISH_START.

Sequence editing mode with predecessor and successor icons and Add Time Lag marked

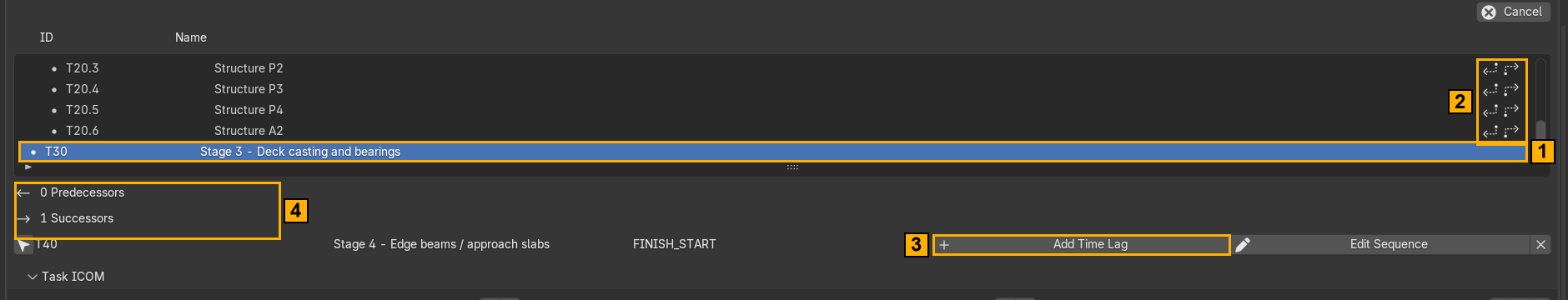

Step 9 – sequence mode with T30 active. 1 the active task · 2 every other row shows ← / → icons: ← makes that row a predecessor, → a successor · 3 Add Time Lag / Edit Sequence on an existing link · 4 the list of predecessors / successors (here T30 has 0 predecessors — T20 → T30 is not linked yet).

▶ Click path – four times (T10→T20, T20→T30, T30→T40, T40→T50)

  1. Select the later task, e.g. T30 1.
  2. Edit → sequence icon (third icon of the tool row) – the mode label changes to Cancel and arrows appear on the other rows.
  3. On the row of the task that must come first (T20) click the ← icon 2 – it becomes T30’s predecessor.
  4. To delay a task, use Add Time Lag 3 on the link, or Edit Sequence to change the type. New links default to FINISH_START.
  5. Finish with Cancel (it only leaves sequence mode).

Afterwards you can use Schedule tools → Re-calculate Schedule so dates follow the dependencies and lags. Re-check the dates: it can move tasks.

Tip

Dependencies do not change the animation unless dates or lags change. Adding a link between tasks that already have fixed non-overlapping dates alters nothing visible.

Step 10 · Check the data, then save the IFC

Schedule tools with Select Unassigned and Re-calculate Schedule marked

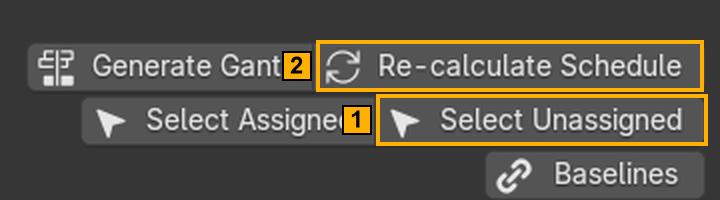

1 Select Unassigned · 2 Re-calculate Schedule (Schedule tools).

▶ Click path

  1. Schedule tools → Select Unassigned 1 – selects every element that has no task.
  2. Look at the selection. On this bridge only the alignment (IfcAlignment) should remain, because it is not construction geometry. Any physical element left is missing from your plan.
  3. Check dates and dependencies once more.
  4. File → Save IFC Project As… (or Ctrl+S) and save as Bridge_4D_working.ifc.

Saving the .blend is not saving the IFC

The schedule lives in the IFC. Blender’s own save only stores the scene. Save the IFC first, the .blend after.

Reference result for this bridge: 151 of 151 physical elements had a task. Compare with your count.

Step 11 · Animation settings

The task tree must stay active (Step 4). The Animation Tools panel is hidden until a schedule is active and is collapsed by default.

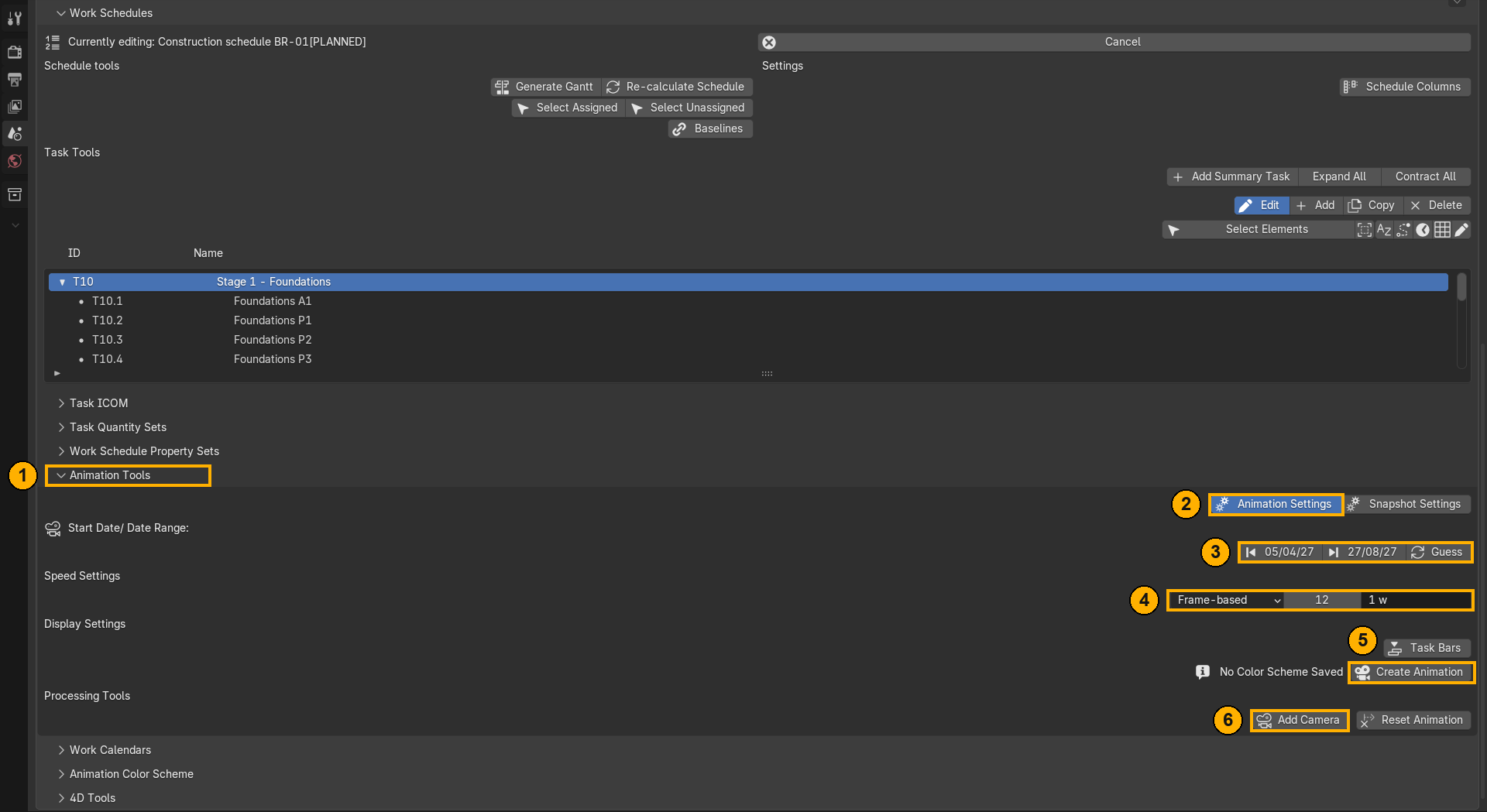

Animation Tools panel with Animation Settings, Guess, Speed Settings, Create Animation and Add Camera marked
Step 11 – Animation Tools (screenshot from the reference model). 1 expand the panel · 2 Animation Settings · 3 Guess · 4 Speed Settings · 5 Create Animation · 6 Add Camera.

▶ Click path

  1. Expand Animation Tools 1.
  2. Switch on Animation Settings 2 (the alternative, Snapshot Settings, gives a single date instead of a film).
  3. Click Guess 3. Bonsai reads the earliest start and latest finish from the tasks: 05/04/27 → 27/08/27. Do not type dates by hand.
  4. Speed Settings 4: choose Frame-based, set 12 frames per 1 w (week).
Frames per week Total frames Film at 24 fps
24 (default) ~494 ~20.6 s
12 (recommended) ~246 ~10.3 s
6 ~124 ~5.2 s

Other modes: Duration-based (fix the film length) and Multiplier (speed vs. real time).

Step 12 · Create the animation and check it

▶ Click path

  1. Click Create Animation 5 (camera icon).
  2. Press Space in the 3D viewport to play, or drag the timeline to any date.

Bonsai now keyframes visibility and colour of every assigned element, sets the scene frame range and switches viewport shading to Object colour (without it all elements would look the same).

Bridge in the viewport during the animation: green deck under construction, grey supports completed

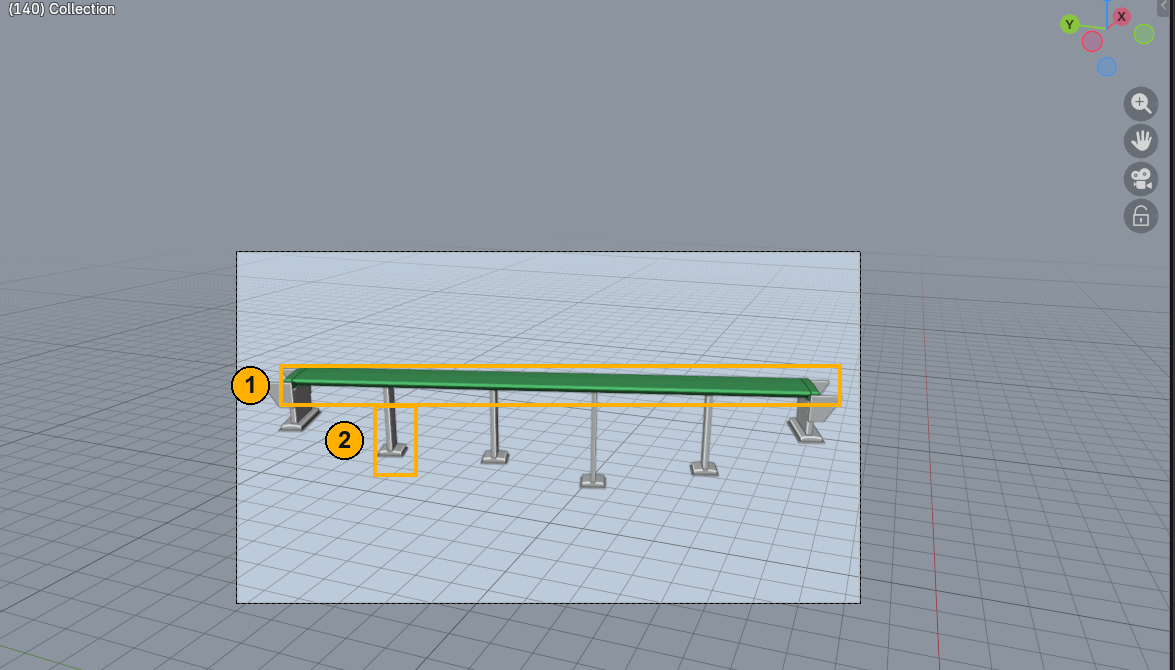

Step 12 – result in the viewport. 1 green = under construction · 2 light grey = completed. Elements not yet built are invisible.

The finished film is the video at the top of this article: hidden, then green, then light grey, stage by stage.

Inspect frame 1 (should be empty), the transition between stages, and the last frame (everything light grey, no green).

Step 13 · Render the MP4

Bonsai builds the animation in the scene; the rendering itself is plain Blender.

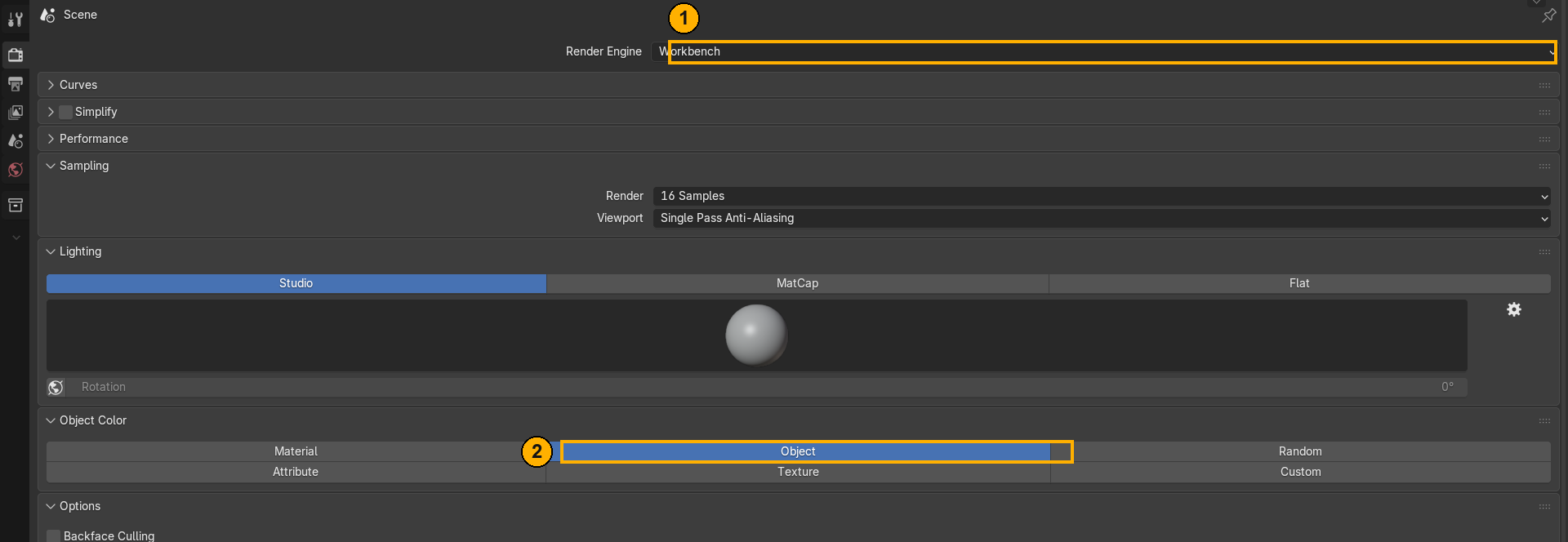

Blender render properties: Workbench engine and Object color marked
Step 13 – Properties → Render. 1 Render Engine = Workbench · 2 Object Color = Object.

▶ Click path

  1. Add Camera 6 (Animation Tools → Processing Tools), frame the bridge, and press Numpad 0 to look through it.
  2. Properties → Render: Render Engine Workbench 1; in the Color section pick Object 2. Workbench draws object colour directly and is by far the fastest engine.
  3. Properties → Output: 1920 × 1080, 24 fps. The frame range was set by Bonsai.
  4. In Blender 5.x first set Media Type → Video, otherwise FFmpeg is not listed. Then File Format FFmpeg Video, Container MPEG-4, Video Codec H.264.
  5. Render → Render Animation (Ctrl+F12).
  6. Save the .blend to keep camera and settings.
✔ Checkpoint You have an MP4 of the bridge being built from 5 April to 27 August 2027.

Troubleshooting

Symptom Cause Fix
No Work Schedules panel at all File is IFC2X3 Use IFC4 or IFC 4.3
Animation Tools panel missing No schedule is active Step 4: click the first icon on the schedule row
Element visible from frame 1 Not assigned to any task (or only via decomposition) Step 7/8; use Select Unassigned
Nothing animates for a task No dates, or no outputs Steps 6 and 7
Everything is one colour Viewport not in Object colour Bonsai sets it automatically; otherwise Shading → Color → Object
Green disappears almost immediately Linear interpolation between the green and grey keyframes Graph Editor → select Object Color keys → T → Constant
Long dead stretches in the film Child tasks share dates, or tasks are short compared with their stage Stagger dates, add lag times, or use a smaller frames-per-week value
FFmpeg not in the format list Blender 5.x hides it under image media type Media Type → Video first
Start over with the animation — Animation Tools → Processing Tools → Reset Animation

Shortcuts worth knowing

  • Import a ready schedule instead of typing it: File → Import supports CSV, Primavera P6 (.xml / .xer), Asta Powerproject (.pp) and Microsoft Project (.xml). You still do Step 7 (linking to geometry) yourself. Export goes the other way (File → Export: P6 or MS Project XML).
  • Snapshot of a single date: Animation Tools → Snapshot Settings → pick a date → Create SnapShot.
  • Gantt chart: Schedule tools → Generate Gantt (opens in the browser).
  • Script: for a model that already has a schedule, bonsai_4d.py builds the animation and the MP4 in one command and also handles the railing and colour-interpolation issues automatically.

Cheat sheet

# Do this Where
1 Load the IFC File → Open IFC Project
2 Find the panel Properties → Scene → Costing and Scheduling → Construction Scheduling
3 Plan + schedule (PLANNED) Work Plans +, Work Schedules +
4 5 stages first icon on schedule row → Add Summary Task → Edit → pencil
5 12 child tasks select T10 / T20 → Add
6 Dates Edit → clock icon → ScheduleStart / Finish → ✓
7 Assign geometry select task, select elements in 3D → Task ICOM → Outputs +
8 Railing members assign IfcMember objects to T50 as well
9 Dependencies Edit → sequence icon → ← / → on rows
10 Check + save Select Unassigned → Save IFC Project As…
11 Animation settings Animation Tools → Animation Settings → Guess → Frame-based 12 / 1 w
12 Create Create Animation → Space
13 Render Add Camera → Workbench + Object colour → FFmpeg H.264 → Render Animation

Enrolment open · closes 16 October

IFC Infrastructure Masterclass, Edition 2
From the structure of the file to a model that passes

This bridge is part of the model set we work on live. The schedule you have just built is one piece; the course covers the whole file: spatial structure, alignment and stationing, georeferencing, geometry and the data the client checks.

Every option includes the IFC 4.3 infrastructure models (bridge, road, rail, tunnel, utilities in one coordinate system), the 162-page Mapping Guide and the full Road to BIM IFC Viewer. In Workshop 6 we close the loop with IDS, BCF and AI: Claude Code and Codex write the checks, you learn to verify them.

Six live workshops · Mondays from 26 October 2026 · recordings with lifetime access

See the programme →

From €459. 14-day money-back guarantee on Practical Knowledge and Full Access. Enrolment closes on 16 October.

If you want to go further than one example, the IFC Infrastructure Masterclass works through the whole delivery workflow across six workshops – objects, relationships, properties, classification and information structure, on real infrastructure models.

Did you like that post ? Share it with others !

We spend a lot of time and effort creating all of our articles and guides. It would be great if you could take a moment to share this post !

Share:

Comments:

Subscribe
Notify of
guest
0 Comments
Oldest
Newest

Author:

Download BIM CASE STUDIES:

After reading this guide you will learn:

  • How BIM is used on the biggest projects in Norway
  • What were the challenges for the design team and how were they solved
  • What were the challenges on the construction site and what was our approach to them

Newest articles:
